A multi cable transit 1 order confirmation looks routine on our order desk, yet one wrong frame code can stall a BESS container line for weeks. So we check every line.
Check the part number and transit frame type, frame dimensions against your 120-frame cutouts, sealing module quantities and cable diameter range, fire rating and IP certification scope, unit and extended pricing, freight terms, delivery window, and spare module availability before you approve a multi cable transit order confirmation.
Below, I walk through each group of line items in the order I review them. The goal is simple. You should be able to prove fit, performance, cost, and schedule from the confirmation alone, before any rubber is molded or any frame is welded.
How Do I Verify Frame Dimensions Match My Existing 120-Frame Cutouts Before Approving the Order?
Last quarter our QC team pulled a TSC frame from the line because the buyer's cutout drawing and the order line disagreed by a few millimetres.

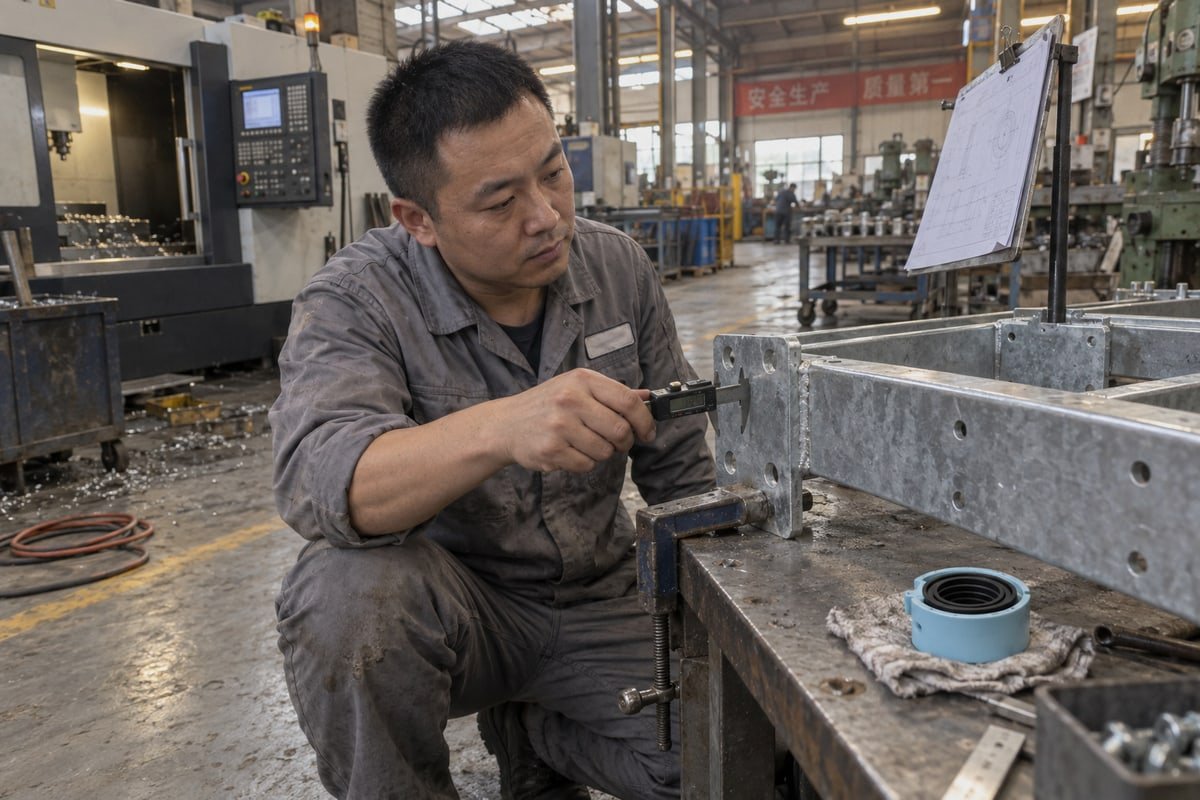

Compare the confirmed frame dimensions, opening size, flange width, bolt pattern, and mounting method against your existing 120-frame cutout drawing, then request a model cross-reference table and a free validation sample so the frame and sealing modules are proven to fit before you approve the order.

A multi cable transit order confirmation is not a generic packing slip. The frame is the one part that has to fit a hole someone else already cut. That is why I treat frame dimensions as the first line item to verify, before price and before delivery.
Which frame fields to compare
| Field on the confirmation | What I check it against | Why it matters |
|---|---|---|
| Transit frame type | TSC square or TSR round, single or multi-opening | The wrong family will not accept your sealing modules at all |
| Outer frame dimensions | Length, height, and depth on your cutout drawing | A drop-in second source must land in the existing hole |
| Clear opening size | Internal opening in millimetres | This sets how many sealing modules, stayplates, and end packing pieces fit |
| Flange and bolt pattern | Hole count, spacing, and hole diameter | Bolted frames must align with the studs already on the panel |
| Material grade | Galvanized carbon steel or stainless steel as specified | Marine and offshore projects often reject the wrong grade at inspection |
| Mounting method | Welded, bolted, or cast-in | The method must suit the bulkhead or wall substrate |
Mounting configuration deserves its own check
Welded frames belong on steel bulkheads. Bolted frames suit switchgear panels 2 and modular data center walls. Cast-in frames go into concrete before the pour. The confirmation line should name one of these, not just a model number. If it does not, I ask the supplier to add it.
Prove the fit before you sign
Our step-core EPDM modules are dimensionally compatible with common 120-frame standards. That claim is only useful if you can test it. So I always ask buyers to do three things. First, request the cross-reference table that maps their existing model to the DEWIN model. Second, request a free validation sample. Third, place that sample in a real cutout on the shop floor. Only then approve the line.
What Certification and Test Documents Should I Request Alongside My Order Confirmation?
A sourcing manager in Germany once asked us for the BV factory approval before he asked for the price. He had the right order of priorities.
Request the fire rating certification for A-0 or A-60, the IP68 ingress test report, watertight and gas-tight pressure test results between 0.01 and 0.4 MPa, ISO 9001 and IATF 16949 certificates, the BV factory approval, and material compliance declarations covering halogen-free EPDM, REACH, and RoHS.

Documents are line items too. I list them on the confirmation with a status, just like a frame or a module. If a document is missing, the line is incomplete. This is where I answer a common objection. Some suppliers argue that a short confirmation is fine when the purchase order is already detailed. I disagree. The confirmation is the supplier's statement of what they will actually deliver. If it does not restate the certification scope, you have no written proof that they understood it.
The document set I expect a buyer to ask for
| Document | What it proves | When to request it |
|---|---|---|
| Fire rating certification (A-0 / A-60) | The transit assembly holds the fire class for the tested configuration | At quotation, and confirm scope on the order line |

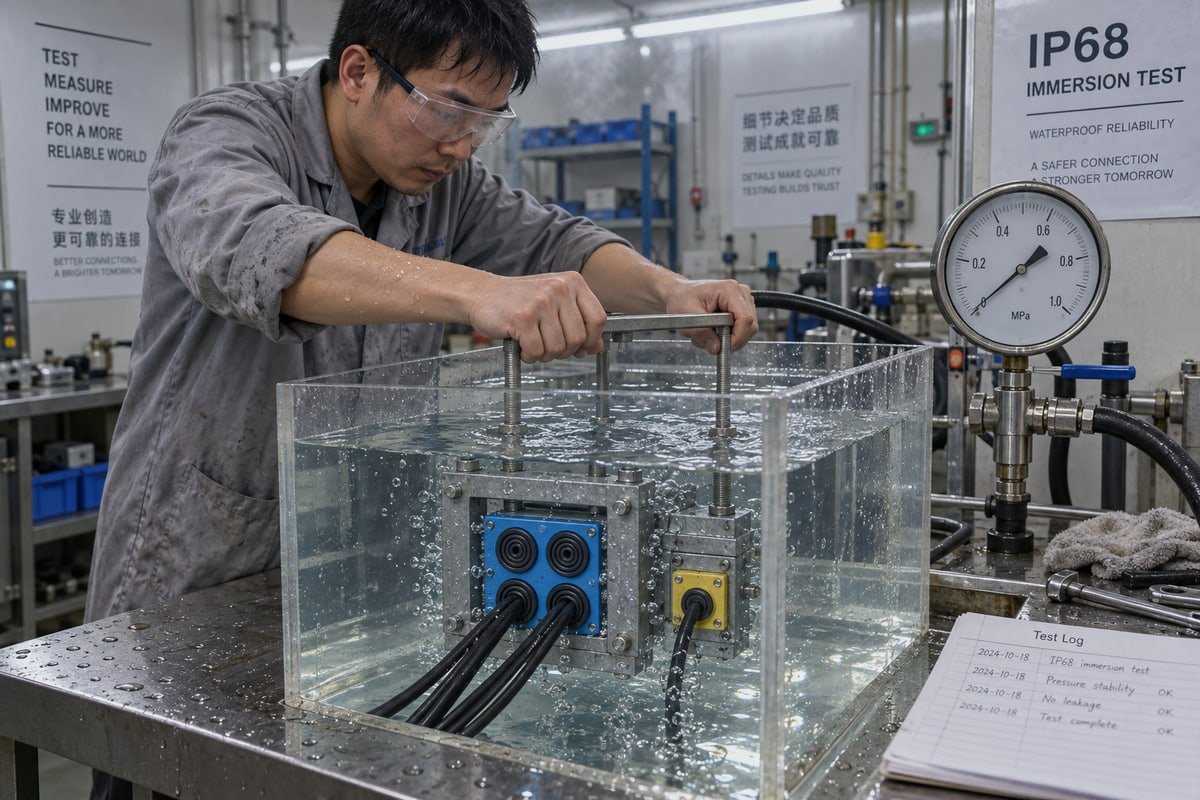

| IP68 ingress protection report | Dust and water ingress performance of the sealed transit | With the confirmation |
| Watertight / gas-tight pressure test (0.01–0.4 MPa) | The compressed sealing modules hold the stated pressure | With the confirmation, or on request per project |
| ISO 9001 and IATF 16949 certificates | The quality management system behind every batch | During supplier qualification |
| BV factory approval | Third-party recognition of the production site | During supplier qualification |
| Material declarations (halogen-free EPDM, REACH, RoHS, LSZH properties) | The elastomer meets environmental and smoke requirements | Before release for European projects |
Match the certificate scope to the line item
A certificate is only valid for what was tested. So I compare three things on every line. The frame type on the certificate must match the frame type ordered. The module sizes tested must cover the cable diameter range 3 on your cable schedule. The compression hardware, meaning the compression wedge and stayplates, must be the same type as the hardware confirmed. Project-specific approvals such as ATEX or DNV are separate. If your project requires them, they need their own line and their own status.
Hardware that affects the certified seal
Buyers sometimes treat lubricant as a consumable. It is not. Only the approved assembly lubricant should be listed, because non-approved lubricants can degrade elastomeric seals 4 over time. Grounding or EMC features for sensitive data cables should also appear as their own line if your specification calls for them.
Which Cost and Pricing Details Should I Double-Check to Confirm Real Savings on My MCT Order?
Every quote we send weighs a lower unit price against the extra testing and export paperwork 5 a European buyer expects. Real savings must survive that trade-off.
Verify unit price, extended price, discounts, tax, freight, and total on each line, then confirm the quoted 40–60% saving on your MCT order still holds after adding compression wedges, stayplates, end packing, lubricant, tags, samples, and test documents that a full transit kit requires.

A cheap module line and an expensive total are a common pattern. The module price looks good. Then the hardware, documents, and freight arrive as separate surprises. I avoid this by insisting that the confirmation shows a complete kit, priced line by line. Here is what a weak line and a strong line look like side by side.
A weak confirmation line versus a strong one
| Element | Weak line | Strong line |
|---|---|---|
| Description | "MCT kit, 1 set" | TSC frame, material grade, opening size, mounting method, plus module sizes by cable diameter range |
| Quantity | 1 set, contents not listed | Frame, sealing modules by size, stayplates, compression wedge, end packing, lubricant, each counted |
| Unit and extended price | One lump sum | Unit price and extended price per component |
| Discounts and tax | Not shown | Discount line and tax line stated separately |
| Freight | "Excluded" | Incoterm named, freight cost or responsibility stated |
| Documents | Not mentioned | Test reports and declarations listed with status |
Hidden cost items I look for
- Compression hardware. A missing compression wedge or a short count of stayplates means a site order at rush freight rates.
- End packing and blank blocks. These fill unused space and preserve spare capacity. Buyers often forget them.
- Approved lubricant. Type and volume should match the number of modules.
- Identification tags. Project-specific tags, location markers, or QR codes for BIM and lifecycle software may carry a small unit cost. They should still be visible.
- Validation samples. We supply these free, and I ask buyers to check that the confirmation says so.
- Documentation. Export paperwork and test documents should not appear as a surprise fee.
How I judge whether the saving is real
I take the strong line total, including freight to the delivery destination, and compare it with the incumbent supplier's total for the same complete kit. Our factory-direct pricing normally lands 40–60% below common brand pricing on that like-for-like basis. If a confirmation only shows a module price, that comparison is not yet possible, and I would not approve it.
How Do I Make Sure Lead Times and Spare Module Availability Are Clearly Stated in My Confirmation?
We learned early, back when we started in 2013, that a delivery date without a change deadline is only a wish.
Insist that the confirmation states a supplier reference number, a firm delivery window per line, a last date to change, freight terms, packaging characteristics, and a separate line for spare sealing modules or blank blocks, with their stock status and reorder lead time written out.

Schedule risk hides in vague wording. "Approximately four weeks" tells a project team nothing about which line ships first or when changes stop being accepted. I review the delivery section of a multi cable transit order confirmation in a fixed sequence.
The review sequence I follow
- Find the supplier reference number. Every later question, from packing list to invoice, ties back to this number.
- Check the delivery window on each line. A frame line and a spare module line may ship at different times. Each should carry its own date.
- Locate the last date to change. After this date, quantities and sizes are frozen. Your engineering team needs this date in their calendar.
- Read the freight terms. The confirmation should name who arranges transport and who pays, plus the ship-to address for the container yard or panel shop.
- Confirm packaging characteristics. Module sizes should be packed and labeled so site teams can identify them without opening every carton.
- Check line status. Structured confirmations mark each line as accepted, changed, or rejected. Partial confirmation of some lines is acceptable only if the open lines are clearly flagged.
Spare capacity is a line item, not an afterthought
| Item | What the line should state |
|---|---|
| Spare sealing modules | Size, quantity, and whether they ship with the main order |
| Blank blocks for spare capacity | Quantity reserved for future cable additions without breaking the certified seal |
| Reorder lead time | Stated in weeks, from the stated production site |
| Cross-reference to incumbent model | So spares can replace an existing brand module in the same frame |
We keep spare sealing modules moving quickly because we run production in Shaanxi, Shandong, and Hunan and make our own molds in-house. That matters for custom sizes as well. When a buyer needs a module for an unusual cable diameter range, the confirmation should show a mold lead time and a production lead time as two separate figures.
Why packaging detail protects the schedule
MCT components are small but project-critical. A missing compression wedge is hard to spot in a mixed pallet. I ask that the confirmation describes the packing method, palletization, and labels, including any project tags or QR identifiers. That way the receiving team can match cartons to the confirmation before the installers arrive.
Fazit
An unchecked confirmation risks rework, failed inspections, and idle installers. Verify fit, certification, complete pricing, and firm delivery lines, and your MCT order protects the project instead of threatening it.
Fußnoten
1. ISO provides international standards for cable penetration seals and transit systems. ↩︎
2. IEEE standards govern the infrastructure and electrical components used in switchgear and data centers. ↩︎
3. The IEC defines international standards for cable dimensions and electrical installation requirements. ↩︎
4. Authoritative Wikipedia entry for elastomers, the primary material used in multi-cable transit sealing modules. ↩︎
5. The European Commission provides official guidelines on customs procedures and export documentation for trade. ↩︎
