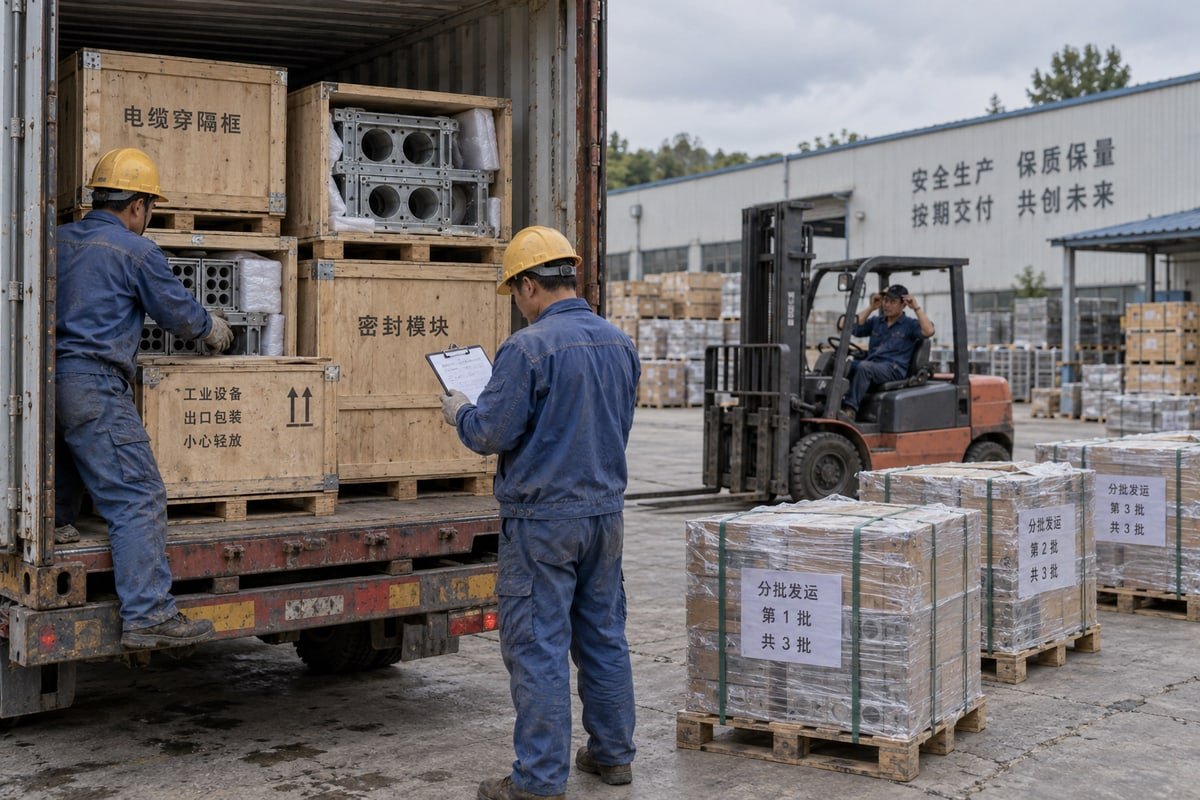

Comparing full container consolidation and batch shipping for MCT construction scheduling (ID#1)

Full container consolidation vs batch shipping 1 decides whether MCT frames leaving our factory arrive when crews need them. Pick wrong and labor idles. Pick right and your critical path holds.

Full container consolidation suits MCT projects with a stable scope and predictable installation dates, because it cuts freight cost per unit and handling. Batch shipping suits phased builds with fragile critical paths, because partial releases keep crews working when one supplier slips.

Multi-cable transit sealing is a small package inside a large build. That is exactly why its delivery timing matters so much. Below, I walk through the decision, the cost and lead-time trade-offs, mixed TSR and TSC loads, and the customs paperwork that ties phased deliveries together.

How do I decide between full container consolidation and batch shipping for my MCT system delivery schedule?

A sourcing manager in Rotterdam asked me to ship the frames early and the modules later. That request taught me the decision starts with the installation sequence, not the container.

Decide by mapping each MCT component to its installation milestone. If frames, modules, and compression units are all needed within one window and suppliers are synchronized, consolidate into a full container. If installation is phased or supplier readiness varies, ship in batches tied to milestones.

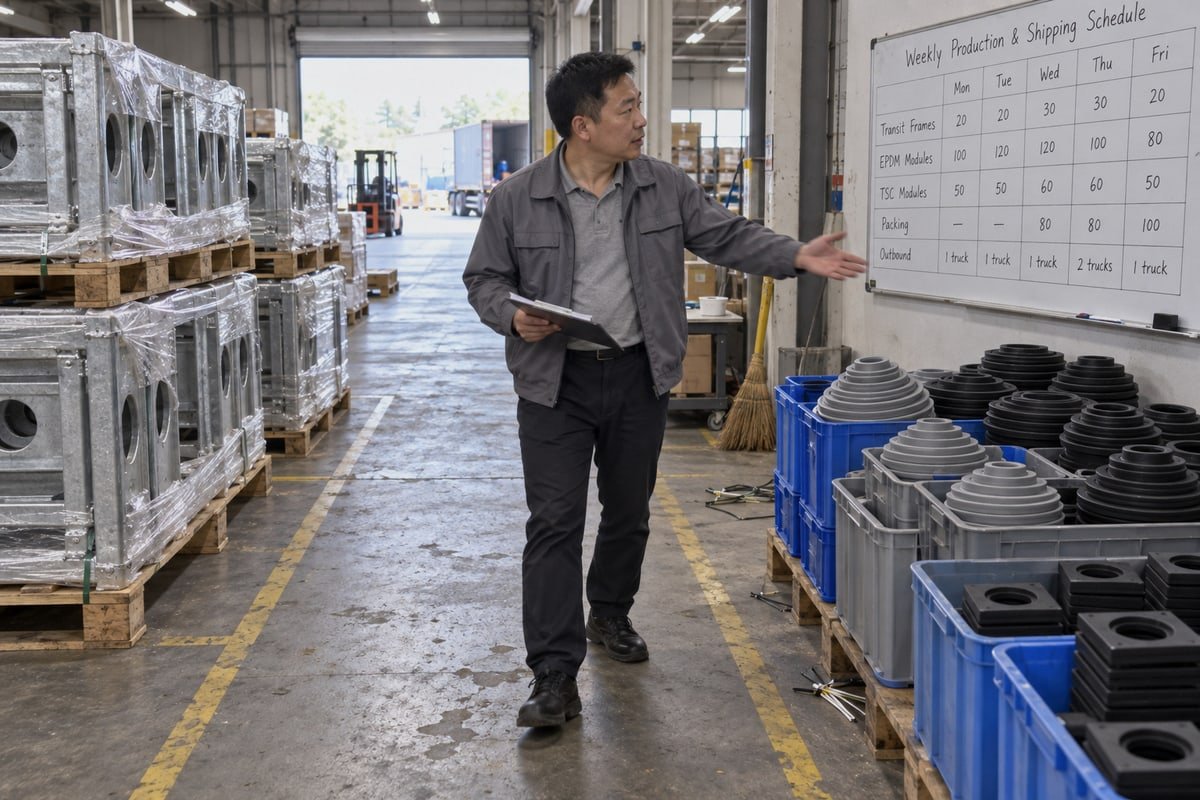

Mapping MCT components to installation milestones for consolidation or batch shipping decisions (ID#2)

Here is the comparison I put in front of buyers before we talk about freight rates at all.

Factor Full Container Consolidation Batch Shipping
Freight cost per unit Lower; one flat container rate Higher; paid per cubic meter
Transit time Shorter; bypasses port consolidation stations Longer; extra consolidation and deconsolidation
Schedule flexibility Low; waits for the last item High; each wave moves when ready
Site arrivals to receive One or few Many
Site storage constraints Needs staging area and unloading equipment Fits smaller laydown areas
Exposure to one late supplier Holds the whole container Holds only that batch
Cargo security Sealed from factory to site More handling in shared loads

Start from the installation sequence, not the port

MCT hardware installs in two distinct phases. Cable transit frames get fixed into wall or bulkhead openings during structural or shell work. TSC and TSR sealing modules, stay plates, and compression units go in only after cables are pulled. In our experience shipping to BESS container builders, those two phases can sit weeks apart. So a single full container often means modules sit on site while frames are still being welded in. That ties up cash and takes space. In modular construction logistics, space is rarely free.

The objection I hear most

Buyers sometimes tell me consolidation is simply superior because it cuts handoffs and freight cost. That is true when the scope is fixed and every supplier ships on the same calendar. It is not true when your site date is uncertain or when a third-party item in the same container is late. Then the whole load waits, and the ripple effect reaches your electrical crew. I treat batch shipping as a risk tool in that case, not a compromise.

Five questions I ask before quoting freight

  1. Is the first installation date fixed, or is it still moving?
  2. How many weeks separate frame installation from module installation?
  3. Does the site have a forklift and a covered laydown area?
  4. Are other suppliers sharing this container, and are they synchronized?
  5. Have we started planning at least 8–12 weeks before the first material need?

If the answers point to a fixed date, one window, and a ready site, I consolidate. If two or more answers are uncertain, I recommend batches.

✔ Consolidation planning should begin 8–12 weeks before the first material is needed on site True
Aligning multiple factories, staging, inspection, and container booking takes weeks, and starting late is the most common reason a consolidated load misses its installation window.
✘ Full container consolidation is always the lower-risk option because it involves fewer shipments False
Fewer shipments also means one late item can hold every other component in the container, which concentrates schedule risk rather than reducing it.

What lead-time and cost trade-offs should I expect when switching from batch shipments to full container loads?

Every quote we prepare weighs two numbers against each other: the flat container rate and the calendar days lost while modules wait for the last frame to finish.

Switching from batch shipments to full container loads lowers freight cost per unit and transit time, since sealed containers bypass port consolidation stations. The trade-off is a longer front-end lead time, roughly eight weeks of staging and inspection, plus storage fees if arrivals miss a 5–7 day window.

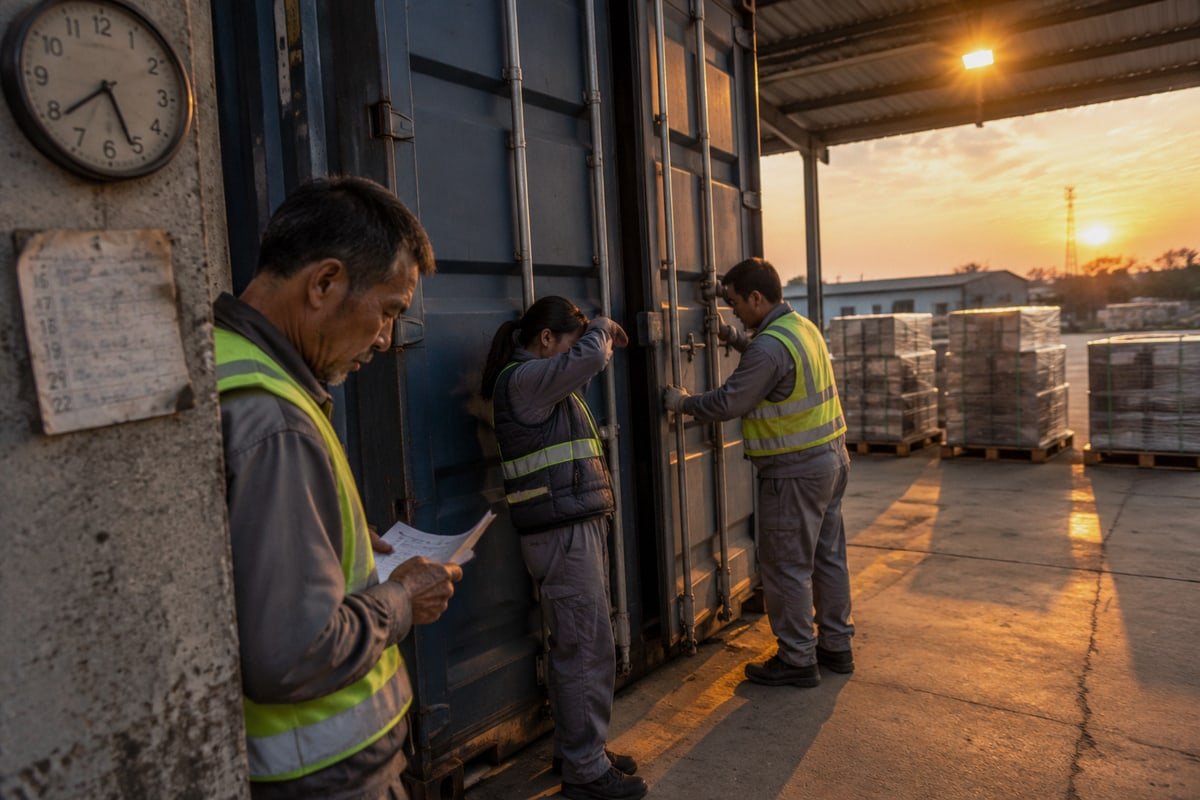

Lead-time and cost trade-offs when switching from batch shipments to full container loads (ID#3)

The freight cost optimization 2 case for consolidation is real, but it only shows the sea leg. The full picture includes time before the port and cost after the port.

Cost or Time Item Full Container Load Batch Shipment
Ocean freight basis Fixed container cost, shared across all cargo Charged per cubic meter occupied
Front-end staging About 8 weeks across manufacturing, warehouse staging, inspection, dispatch Each wave ships as it finishes
Port handling No CFS consolidation or deconsolidation Added days at both ends
Damage risk Low; sealed door to door Higher; more touches in shared loads
Inventory carrying costs Higher; all material arrives at once Lower; supports just-in-time delivery
Receiving events on site One Several, each needing checks and staging

Where the savings come from

Fixed container costs reward filling the box. When our TSC modules, frames, and compression units from three production sites all go into one container, the freight per frame 3 drops sharply. For small volumes, however, paying per cubic meter in a batch is cheaper than paying for empty container space. There is a crossover point. I ask buyers to send the bill of materials so we can measure CBM and weight before anyone books space.

Where the time goes

A consolidated load follows a staged timeline. Manufacturing finishes first. Goods then move to a consolidation warehouse near the port for staging, re-palletizing, and pre-shipment inspection. Then the container is packed and dispatched. Spread across multiple suppliers, that sequence takes about eight weeks. Project lead times therefore grow at the front, even though the sea leg gets shorter. The staging warehouse also charges storage. Keeping all arrivals inside a 5–7 day window avoids most of those fees. Miss the window and the savings shrink.

The objection from the other side

Some project teams argue batch shipping protects the schedule, so cost does not matter. I push back gently. Each batch is one more truck at the gate, one more count against the packing list 4, and one more crate to store. Material handling efficiency drops with every extra arrival. My honest answer is that batches cost more in total logistics spend. They buy flexibility, and you should decide whether you actually need it.

Can I mix TSR and TSC modules in one consolidated shipment without risking installation delays on site?

Our Shaanxi packing team labels every carton with its frame ID before crating. The habit started after one mixed load arrived sorted by product type, not by wall opening.

Yes. TSR round modules and TSC square modules can share one consolidated container without installation delays, provided the load is packed by penetration location, each crate carries a frame ID and phase code, weight is distributed evenly, and the packing list matches the site's installation sequence.

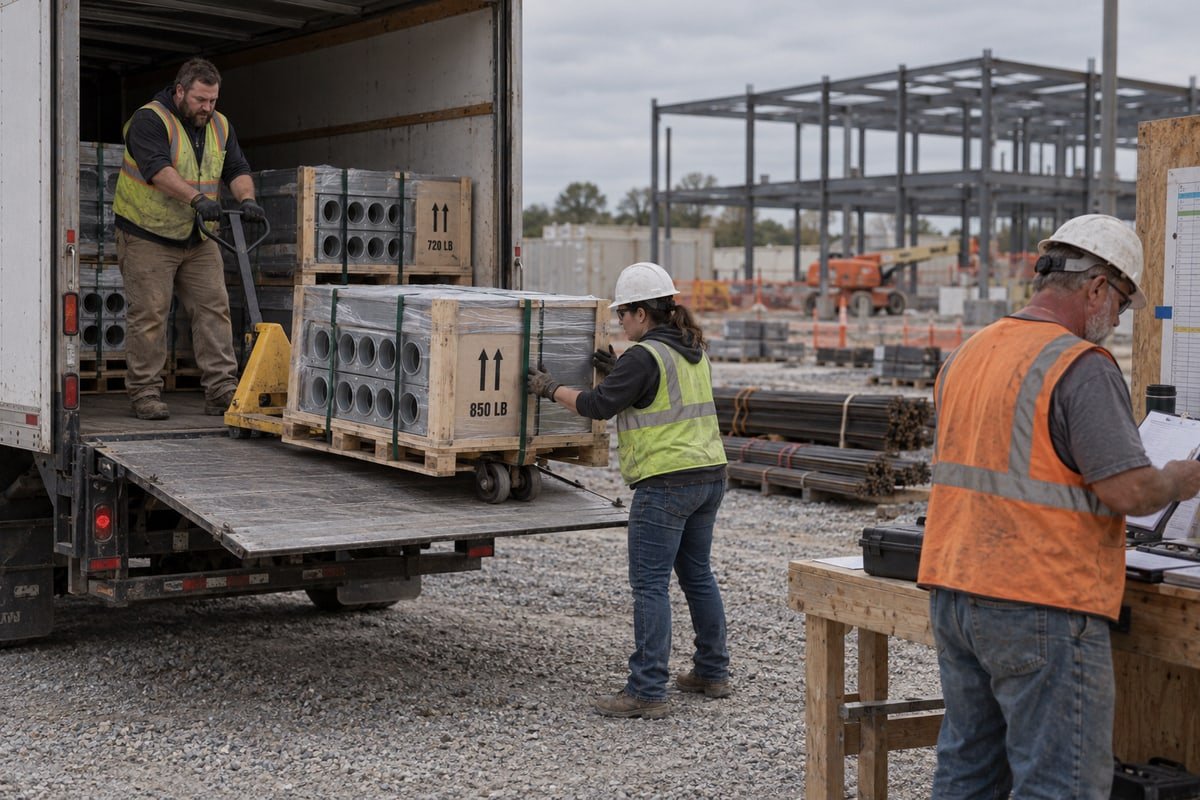

Packing TSR and TSC modules together in one shipment without causing installation delays (ID#4)

Mixing product lines is not the risk. Mixing them without a plan is the risk. A container packed by product family forces the site crew to open every crate and sort by opening. A container packed by penetration location lets them pull one crate per wall and install straight from it.

Pack by opening, not by product line

The just-in-sequence idea from automotive logistics applies well here. Frames and stay plates are foundational. They install first. TSC square modules and TSR round assemblies install after cable pulling. So a mixed load should be layered in reverse installation order. Frames sit at the door end for early unloading. Modules sit deeper. When we build a load like this, we mark each crate with the frame ID, the phase code, and the module count for that opening.

Our load-plan checklist

  1. Confirm the penetration schedule from the customer's drawings or STEP files.
  2. Group modules, stay plates, and compression units per frame.
  3. Measure CBM and gross weight per crate before sealing.
  4. Place galvanized steel frames low and central for weight distribution.
  5. Reinforce crates holding compression units, because the bolts and plates are dense.
  6. Photograph each crate open and closed for the packing file.
Component Typical Packaging Load-Plan Note
Cable transit frames Bolted timber crate Heaviest item; floor level, spread across the container
TSC square modules Cartons on pallets Stack by frame ID; label module size and count
TSR round assemblies Individual boxes on pallets Keep with matching sleeve or opening reference
Compression units and stay plates Reinforced crate Dense hardware; brace to stop shifting
Spare sealing modules Separate carton set Mark as spares so site does not install them by mistake

Why fewer sizes make mixed loads easier

Our modules use step-core, halogen-free EPDM. One module size covers a range of cable diameters. That cuts the number of SKUs in a load and cuts the chance of the wrong size arriving at the wrong opening. Because our modules are dimensionally compatible with common 120-frame standards, a site that already has frames from another supplier can receive our modules as a drop-in second source without changing the load logic. The EPDM itself is stable in transit, so a sealed container gives all the environmental protection the modules need.

✔ Packing a mixed MCT load by wall opening rather than by product type removes on-site sorting True
When each crate matches one frame ID and the packing list mirrors the installation sequence, crews open one crate per opening and install directly from it.
✘ Round and square sealing modules must always ship separately to avoid confusion on site False
Confusion comes from poor labeling and load order, not from the module shape; a properly labeled mixed load installs as smoothly as two separate ones and costs less to ship.

How do I coordinate customs documentation and delivery windows when phasing MCT deliveries across multiple construction stages?

The hardest lesson from exporting to the Middle East was simple: a perfect packing list is useless if the phase codes on it don't match the commercial invoice.

Coordinate phased MCT deliveries by issuing one master packing list with a phase code per shipment, matching each commercial invoice and certificate of origin to that code, confirming partial-shipment terms in the purchase order, and fixing delivery windows backward from each stage's first installation date.

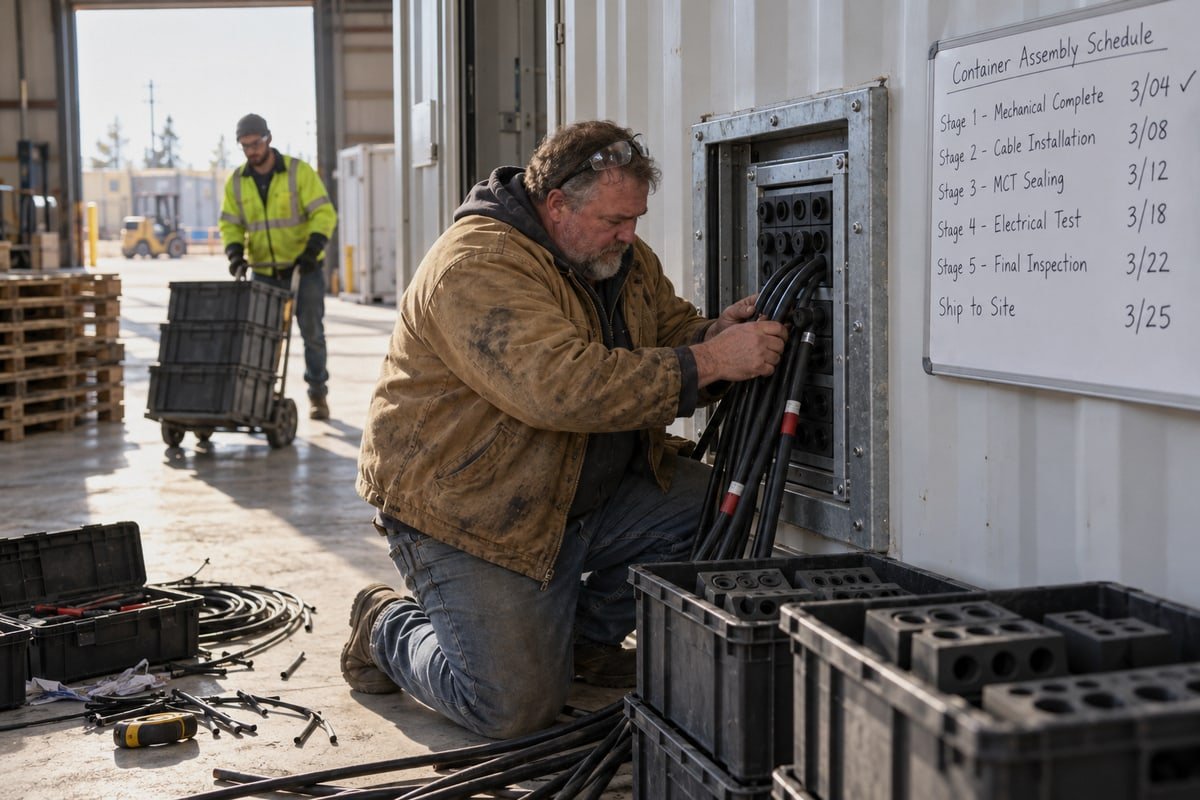

Coordinating customs documents and delivery windows for phased MCT construction deliveries (ID#5)

Phased delivery multiplies paperwork. Each batch clears customs on its own. Supply chain reliability then depends on documents that agree with each other, batch after batch. Here is how we structure it.

Backward planning from the first installation date

I start with the date the first frame must be in the wall. I subtract inland transit, customs clearance, ocean transit, port handling, and staging. That gives the factory dispatch date for phase one. I repeat for each stage. The result is a shared production calendar that the buyer, our three plants, and the freight forwarder all see. Release triggers then sit on that calendar. A trigger can be a floor range, a block of BESS containers, or a milestone handover signed by the site manager. When the trigger fires, that phase ships. Nothing ships early to sit in a yard.

One document set per phase

Document Issued Once or Per Phase What Must Match
Master packing list 5 Once, updated per phase Phase codes, crate IDs, CBM and weight
Commercial invoice Per phase Line items and values tied to that phase code
Certificate of origin Per phase Product descriptions identical to invoice
Bill of lading Per phase Consignee, notify party, container or LCL reference
Test and certification documents Once, with phase one ISO 9001, IATF 16949, BV approval, A-0/A-60 fire, IP68, 0.01–0.4 MPa sealing tests
Partial-shipment authorization Once, in the purchase order Number of phases and allowed windows

Our export desk handles this document set for every shipment. I still recommend the buyer's procurement cycle include one review of the master packing list before phase one leaves. That single check prevents most customs holds later.

Delivery windows and dense sites

Delivery windows should be narrow but realistic. I aim for a window that gives the site two working days of slack. For urban data center builds with strict vehicle size limits, we have used smaller container formats that keep the load sealed while staying road legal. That gives the security of a full container with the maneuverability of a batch. Keeping arrivals to the port staging warehouse within the 5–7 day window applies here too, because storage fees at the staging point follow the same rules whether the load is large or small.

✔ Each phased batch clears customs independently and needs its own matching invoice and origin certificate True
Customs authorities assess the goods physically presented, so every phase requires documents whose descriptions, values, and codes agree with that specific load.
✘ One commercial invoice covering the whole project can be reused for every phased shipment False
A project-wide invoice does not match the contents of any single batch, which triggers valuation questions, inspection holds, and missed delivery windows.

Conclusion

Idle crews cost more than freight. Consolidate when scope is stable; batch when the critical path is fragile. Either way, plan 8–12 weeks ahead and we ship to your sequence.
